A new 5t crane for Bauhalle will be delivered. Therefore the center section of Bauhalle (see picture) will be closed. Area 3.3 can only be reached from the stairs to floor A.
Construction delay
The construction management informed about a delay last week. Phase 3.1 will be finished by end of June 2022 which corresponds a two months delay. This means, that projects can continue till end of June in area 3.2. Area 3.1 will be ready for usage by beginning of July.
Limited support
Due to absences of Bauhallenteam there will be limited support from 1st of April to mit of May 2022.
In area 3.2 multiple machines/equipment must be protected while the area gets refurbished. MAST, LUSET and the Hexapod will be protected, also against climatic influences. Specifications of the manufactured were given to the Baumanagement.
Crane work is carried out at Friday 11th of March. The HIF courtyard and northern area can hardly be used for other tasks.

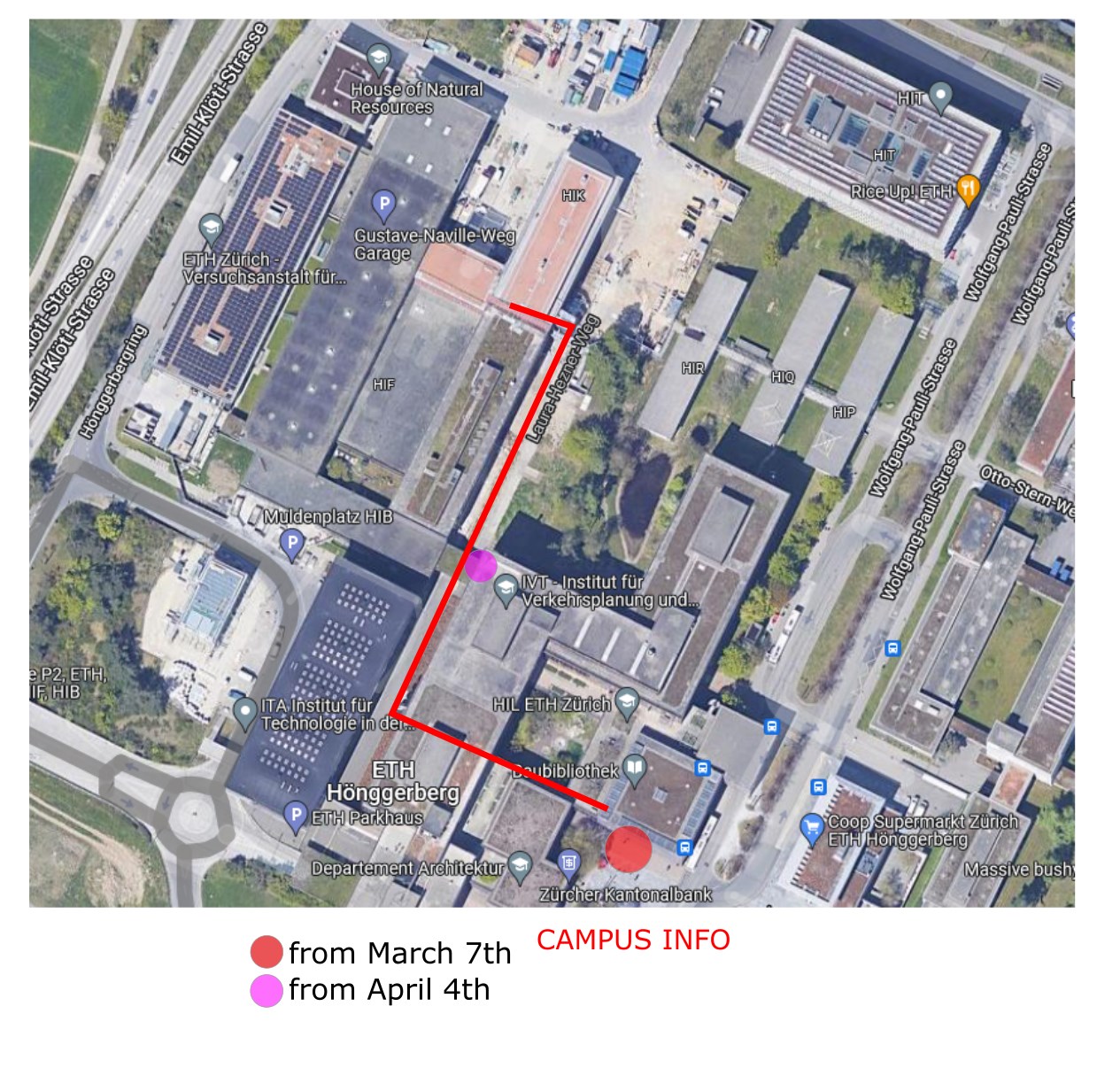

Way2Bauhalle – From March 7th the foot-walk to Bauhalle will change because the construction site for the HPQ building will start. Here you can see the new track:
BauhallenTEAM(+)
Bauhallenteam is searching for team support. Interviews are in progress and we expect to have an additional team member in June/July. Two top candidates are in selection.
HPQ – Specifications
There is an issue with the planned final location of the Hexapod. The problem are the high vibration criteria required by the new HPQ building. (Infomation: https://www.motioncontroltips.com/what-are-vibration-criteria-and-vc-curves/)
It is not clear yet if the Hexapod can be positioned in Bauhalle or on Hönggerberg at all. Also unclear is, if the requirements can be fulfilled with the existing machines in Bauhalle. Discussions are ongoing including Group Chatzi, PHYS and Abteilung Bauten.
Procurement
Hexapod (Chatzi) – delivered, final location unclear
